Planning application fees in England change on 8 December 2026, followed by a 3.5% inflation-linked increase on 1 April 2027. The December increase varies by application type. Check the GOV.UK fee schedule for the fee that applies to your application.
For homeowners, developers and businesses considering a planning application, the timing of submission could therefore make a meaningful difference to the overall cost of a project.
The December 2026 planning fee increase does not apply a single percentage uplift to every application. Instead, the Government has created a new national default fee schedule intended to recover approximately 90% of the estimated cost of processing different application types. As a result, some planning application fees will rise relatively modestly, while others will increase by more than 50%.
Want to avoid the December planning fee increase?
Start preparing your application now. Applicants should allow at least one month for drawings, planning statements, revisions and final approval before submission. Some proposals also require third-party reports that can take several weeks to prepare.
An application cannot normally be prepared the day before the deadline. Contact Planning By Design as early as possible if you are hoping to submit before 8 December 2026.
The regulations were made on 10 November 2026 and come into force on 8 December 2026.
Under the transitional rules, the previous fees continue to apply to applications and requests made before 8 December 2026, even if they are validated or decided later. The validation or decision date is not the fee cut-off.
The December rates apply until 31 March 2027. The annual inflation-linked increase applies from 1 April 2027.

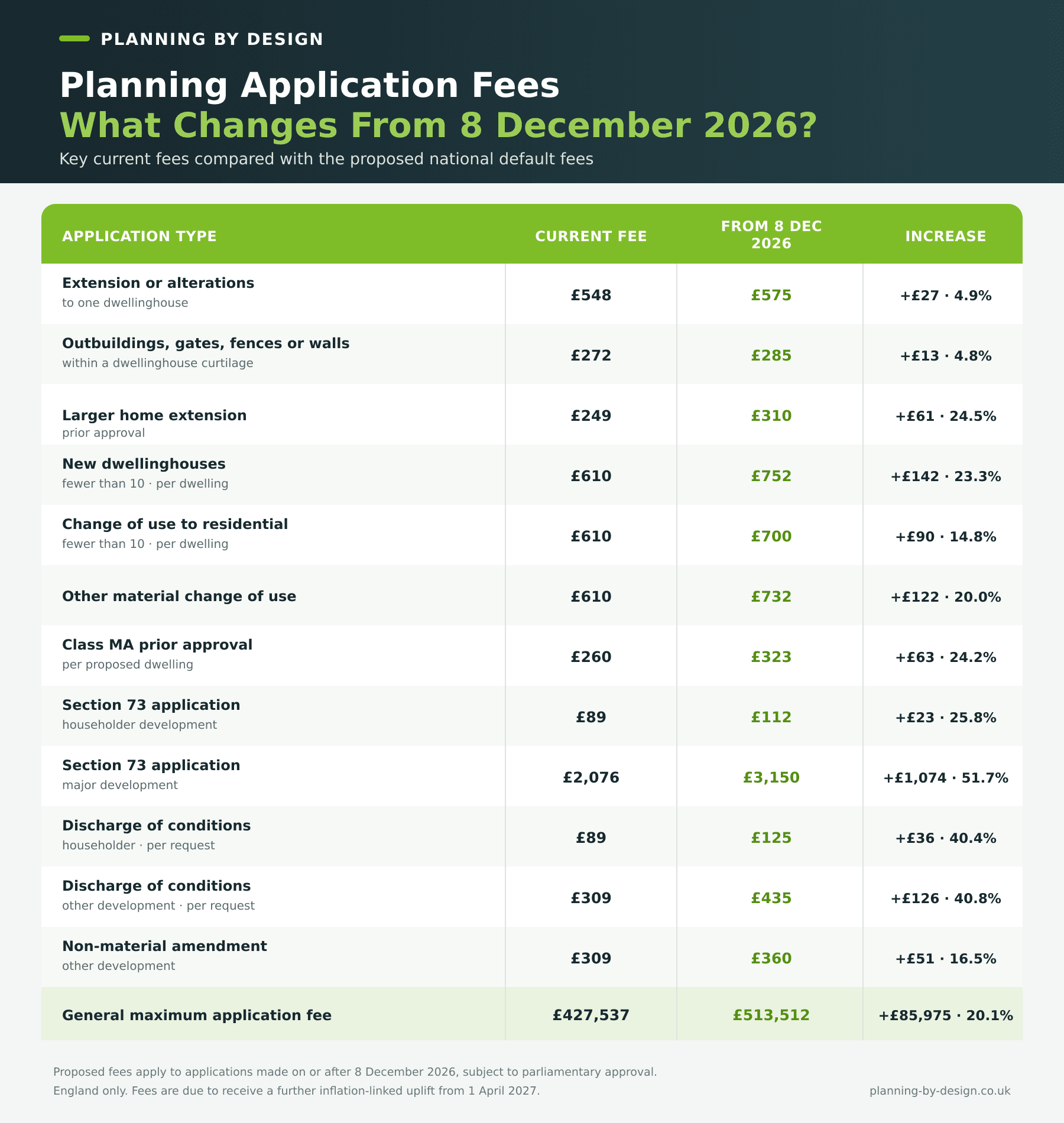

The impact varies considerably depending on the type and scale of development. The table below shows examples of the December changes:

The general maximum planning application fee will also rise from £427,537 to £513,512, an increase of approximately 20%.
The examples above apply to England. The £752 example is the December rate per new dwelling for non-outline applications to build fewer than 10 homes. Outline applications use a separate, site-area-based scale. Check the GOV.UK fee schedule for the applicable rate before submitting.
From 8 December, certain prior approval applications that previously attracted no fee will cost £310. The charge does not apply to every prior approval route.
Fees for some previously charged prior approval routes will also rise. Larger home extension applications will increase from £249 to £310, while Class MA applications to change commercial premises to residential use will rise from £260 to £323 per proposed dwelling.
Applicants relying on permitted development rights should therefore not assume that prior approval will remain a low-cost or free route. The particular permitted development class and the correct fee will need to be checked carefully.
The Government says that no existing planning application fee fully covers the cost incurred by local planning authorities when determining applications. Its evidence identified shortfalls of between 18% and 60%, with Section 73 applications for major development and applications to discharge planning conditions among the categories most frequently considered underpriced.
The new national schedule is intended to recover around 90% of estimated processing costs. The Government argues that the additional income should help improve local authority capacity and support a more efficient planning service.
However, planning fee income is not currently ring-fenced for planning departments. Higher fees therefore do not automatically guarantee faster validation or determination. Applicants will still need to ensure that submissions are accurate, complete and supported by the correct technical information to reduce the risk of avoidable delays.

This means applicants face two increases within less than four months:
If you plan to apply from 1 April 2027, check the updated fee schedule rather than relying on the December figures.
Potentially. The Planning and Infrastructure Act 2025 contains powers that could allow local planning authorities to set their own fees. Separate regulations are expected, under which councils may be permitted to charge up to 30% above the national default where higher costs can be evidenced and justified.
The Government has also consulted on an additional surcharge, expected to be around 10% of the national default fee, to support statutory consultees.
These measures are separate from the December fee regulations and are not yet in force. Nevertheless, they indicate that planning application costs may become more locally variable in the future.
“Applicants should allow at least one month to prepare the drawings, planning statements and supporting documents. While we aim to complete this work within two weeks where possible, revisions and client feedback can add time before everything is approved and ready for submission.
“Some proposals may also require specialist reports covering matters such as ecology, transport, drainage, heritage or trees. These can take weeks or even months to obtain and may be required before submission.
“Anyone hoping to avoid the December fee increase should therefore begin the process now. Leaving it until the deadline is approaching may mean there is simply not enough time to prepare a complete and properly supported application.”
— Aaron Basi, MRTPI, Head of Town Planning at Planning By Design
Where a proposal is sufficiently developed and a valid application can be prepared in time, submitting before 8 December could secure the existing statutory fee. This may produce a meaningful saving, particularly for larger schemes or applications involving multiple dwellings.
However, the submission date should not be considered in isolation. Before applying, applicants should confirm:
Submitting a complete, well-prepared application remains more important than submitting an inadequate scheme purely to avoid a higher fee.
The December changes retain several existing exemptions and concessions. Listed Building Consent stays free, as do applications for works to protected trees and qualifying works for disabled access. The 50% concession for parish and community councils also stays in place.
No application fee is being introduced for planning appeals in England, and the Government has decided not to reinstate the former “free go” for repeat applications.
With the national fee changes taking effect in December, a further inflation-linked rise in April and separate proposals for locally set fees, budgeting and early preparation are becoming increasingly important.
Planning By Design can review your proposal, identify the most appropriate application route and prepare a robust submission that meets the relevant planning and validation requirements.
Planning to submit before 8 December 2026? Start your application now to allow sufficient time for drawings, supporting documents and any specialist reports.
Contact Planning By Design’s award-winning team for a free, no-obligation consultation.
Yes. Planning application fees in England change on 8 December 2026. The increase varies by application type.
The new fees apply from 8 December 2026. The previous fees continue to apply to applications and requests made before that date.
Examples include £575 for alterations or an extension to one dwellinghouse, £752 per new dwelling for non-outline applications to build fewer than 10 homes, £310 for a larger home extension prior approval application and £3,150 for a major development Section 73 application. Fees vary by development type and scale.
The fee for alterations or an extension to one dwellinghouse is currently £548 and will increase to £575 from 8 December 2026. Works within the curtilage of a dwellinghouse, such as certain outbuildings, gates, fences or walls, will increase from £272 to £285.
Some prior approval applications currently charged at £249 will rise to £310. Class MA prior approval rises from £260 to £323 per proposed dwelling. Certain previously free prior approval applications will also cost £310.
From 8 December 2026, the Section 73 fee is £112 for householder development, £3,150 for major development and £608 for other non-major development. This is separate from the fee to discharge conditions.
The fee from 8 December 2026 is £125 per request for householder development and £435 per request for other development, including a condition relating to a Biodiversity Gain Plan.
Under the transitional rules, an application made before 8 December 2026 keeps the previous fee even if validation or the decision happens later.
If you’re applying through Planning Portal in England, you’ll need to submit your application and make sure your payment has cleared before 5 pm UK time on Monday 7 December 2026 to pay the current fees. We recommend submitting and paying by the end of Sunday 6 December to avoid last-minute delays. If you’re paying by bank transfer or cheque, allow extra time for the payment to clear.
No. The December increases vary by application type. The 3.5% annual increase from 1 April 2027 is separate.
Yes. The annual inflation-linked increase is 3.5% from 1 April 2027.
The annual increase from 1 April 2027 is 3.5%, based on September 2026 CPI. Check the GOV.UK fee schedule for the updated cash amounts once published.
Not under the December regulations alone. However, separate regulations are expected to enable local planning authorities to set fees above the national default where higher costs can be evidenced and justified. Applicants should check the fee with the relevant authority before submitting.
No planning appeal fee is being introduced as part of these changes. Other professional or procedural costs may still arise when preparing an appeal.
No. These fee changes apply to planning applications in England.
Yes. The existing exemption for Listed Building Consent stays in place.
No. The former “free go” for repeat planning applications was abolished in December 2023, and the Government has decided not to reinstate it or introduce a reduced resubmission fee.
